Installation guide

Cistern Liner Installation: How to Install Your Custom Liner

A photo-led, step-by-step guide to draining, preparing, lining and filling your cistern, with real photos from a Cistern Liner Co. install.

  • Six clear steps, from confirming the liner to the first fill
  • Confined-space safety and tool control built in
  • Prefer a pro? We install across Eastern Ontario

Download the PDF guide (9 pages)

No exact measurements needed. Phone photos are fine.

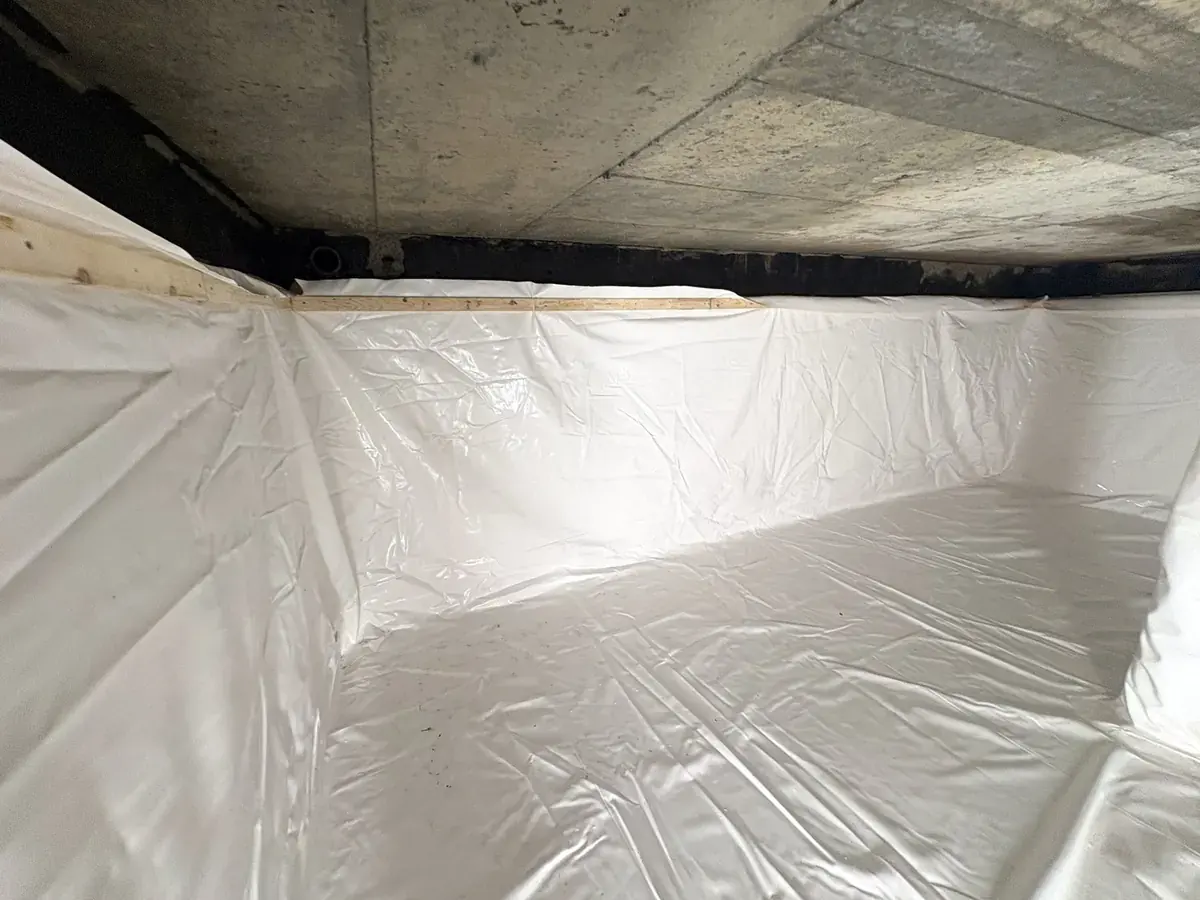

Finished custom cistern liner installed by Cistern Liner Co.

Safety first: a cistern is a confined space

  • Test the air and ventilate before entry. Low oxygen and harmful gases can be present in a cistern that looks clean.
  • Never work alone. Keep an attendant outside the opening at all times, with a way to call for help.
  • Use GFCI-protected power, keep cords and lights up out of any water, and secure lights so they cannot fall.
  • Isolate anything that could refill the cistern or energize a pump while you are inside.
  • Secure the ladder, pad its feet and keep the opening clear. When in doubt, hire a professional.

The golden rule: nothing sharp or hard touches the liner

Keep every drill, driver, bit, knife and Tapcon screw in one padded tool bag, with screws in a closed container inside it.

  • When a tool is not in your hand, it is in the bag. The bag never sits on the liner.
  • Utility knife blades stay retracted or capped between cuts.
  • Count tools and screws in and out of the cistern, every time.
Before you begin

Tools & materials checklist

Read the guide once, start to finish, before installation day. Your project drawings, supplied fittings and manufacturer instructions always take precedence.

Drain & clean

  • Submersible sump pump + discharge hose
  • Bucket to seat the pump at the low point
  • Wet/dry shop vac
  • Stiff push broom
  • LED work lights + GFCI extension cord
  • Ladder with padded feet

Strapping & underlayment

  • Hammer drill + carbide masonry bits
  • Tapcon concrete screws (sized to the maker's chart) + driver bit
  • Wood strapping for the perimeter
  • Level or chalk line, tape measure
  • Rigid foam board for the floor (1″ XPS shown)
  • Foam sheet roll for the walls
  • Duct tape, utility knife, straightedge

Liner, safety & records

  • Your custom liner, drawings and fitting kit
  • Padded tool bag + closed screw container
  • Clean gloves; clean soft-soled footwear or socks
  • Headlamp
  • Eye, ear and dust protection (respirator for concrete dust)
  • Gas monitor / ventilation fan
  • Phone or camera for records

When professional installation is the better call: if entry requires a confined-space permit program, the hatch is small or elevated, the cistern is deep or unusually shaped, the liner is too heavy for your crew, fittings are complex, or the structure or atmosphere is uncertain. Not sure? Send us photos and dimensions and we will advise before you commit.

Step 1

Confirm the liner & cistern

Check everything before you drain a drop.

  • Liner ID and project reference match your cistern.
  • Dimensions (length, width, depth or diameter) and corner layout match your drawing.
  • The access opening is big enough for the folded liner, your crew and your tools.
  • Every penetration (inlet, outlet, overflow, drain, sensor) is identified on the drawing.
  • The fitting kit and attachment hardware supplied for your project are on site.
  • Photograph walls, corners, ceiling, hatch and each pipe before work starts.
Step 2

Drain & prepare the cistern

Remove the water, then get the floor clean.

  1. Take it out of service. Arrange backup water if you need it and isolate inlets, pumps and power.
  2. Pump it down. Seat a submersible pump at the lowest point (a bucket works well) and run the discharge hose well away from your foundation, downslope, to a permitted drainage area.
  3. Vacuum the rest. When the pump loses suction, switch to a wet/dry vac to lift the last water and sludge. Sweep walls and floor toward the vac and repeat until clean.
  4. Light it safely. Hang work lights from the ladder, clear of any water, and keep cords off the wet floor.
  5. Dispose of sludge according to local rules, never onto the liner staging area.

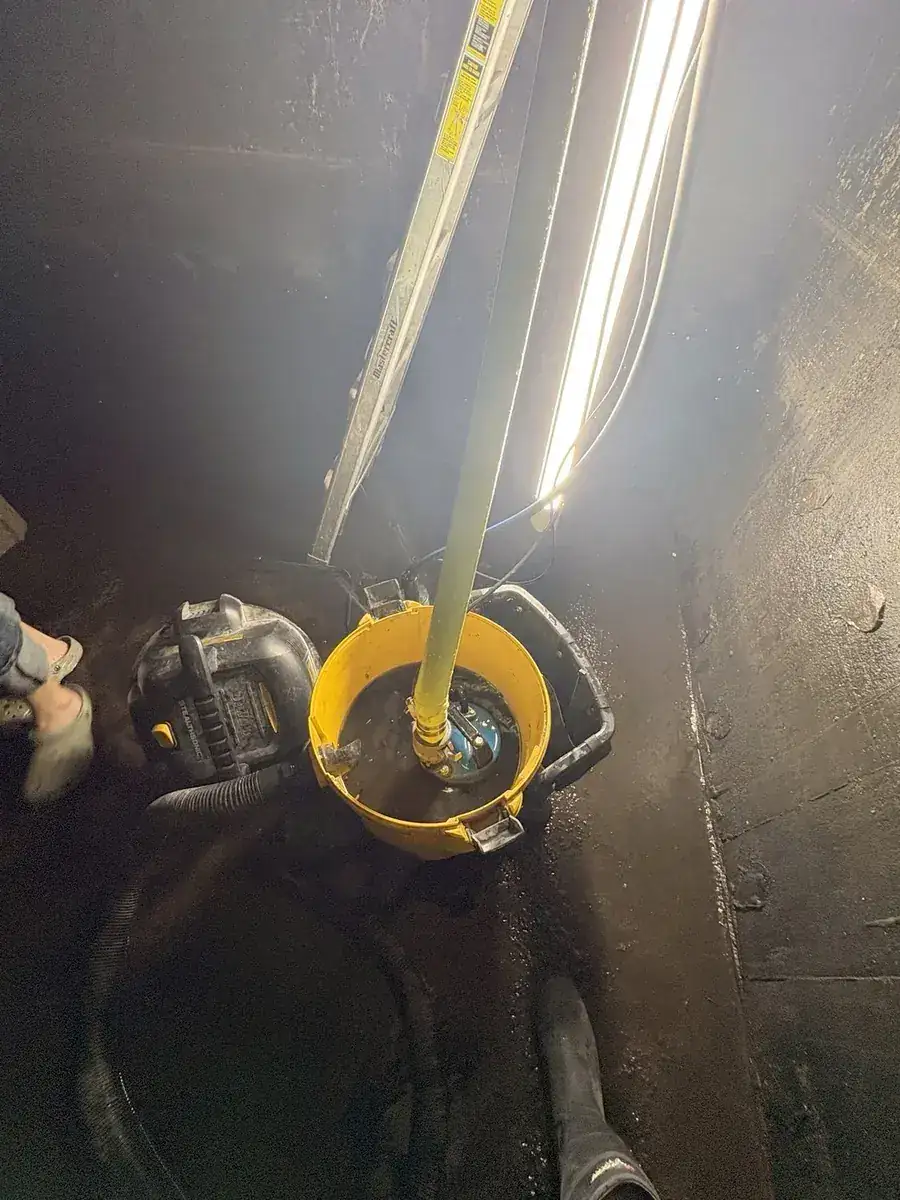

Cistern liner installation: Submersible pump seated in a bucket, discharge hose running up and out.
Photo 1. Submersible pump seated in a bucket, discharge hose running up and out.

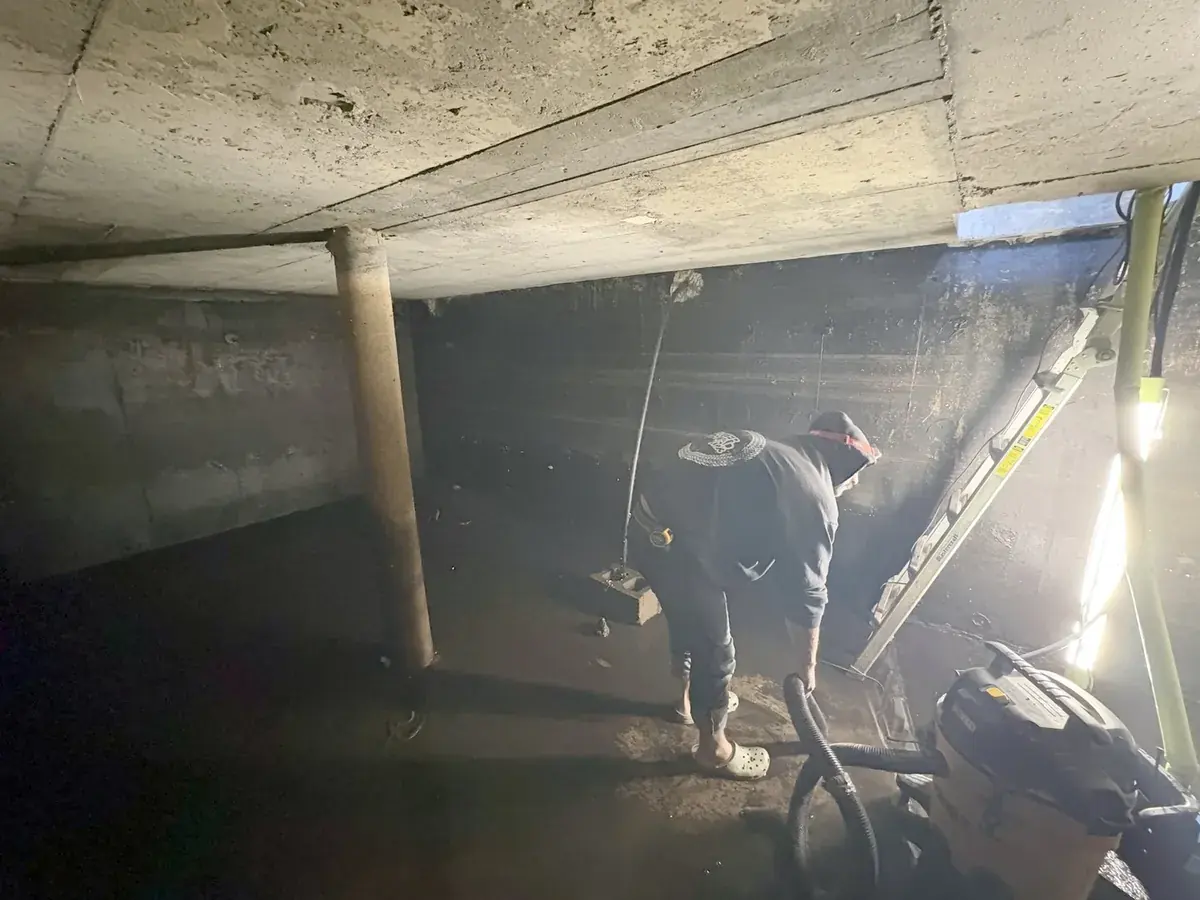

Cistern liner installation: Wet/dry vac removing the last water and sludge from the floor.
Photo 2. Wet/dry vac removing the last water and sludge from the floor.
Step 3

Inspect & prepare the interior

A smooth, safe surface is what protects your liner.

3A. Inspect and clean every surface

  • Look for loose or flaking concrete, sharp aggregate, protruding metal or old anchors. Remove, grind or chip them flush.
  • Loose, peeling or blistered coatings must come off. Smooth, well-bonded coating can stay. Brush and vacuum loose ceiling staining or growth so nothing drops onto the liner (potable-approved cleaners only).
  • Fix active leaks or seepage first. A liner is not a structural repair.
  • Mark and photograph every penetration before it is covered.

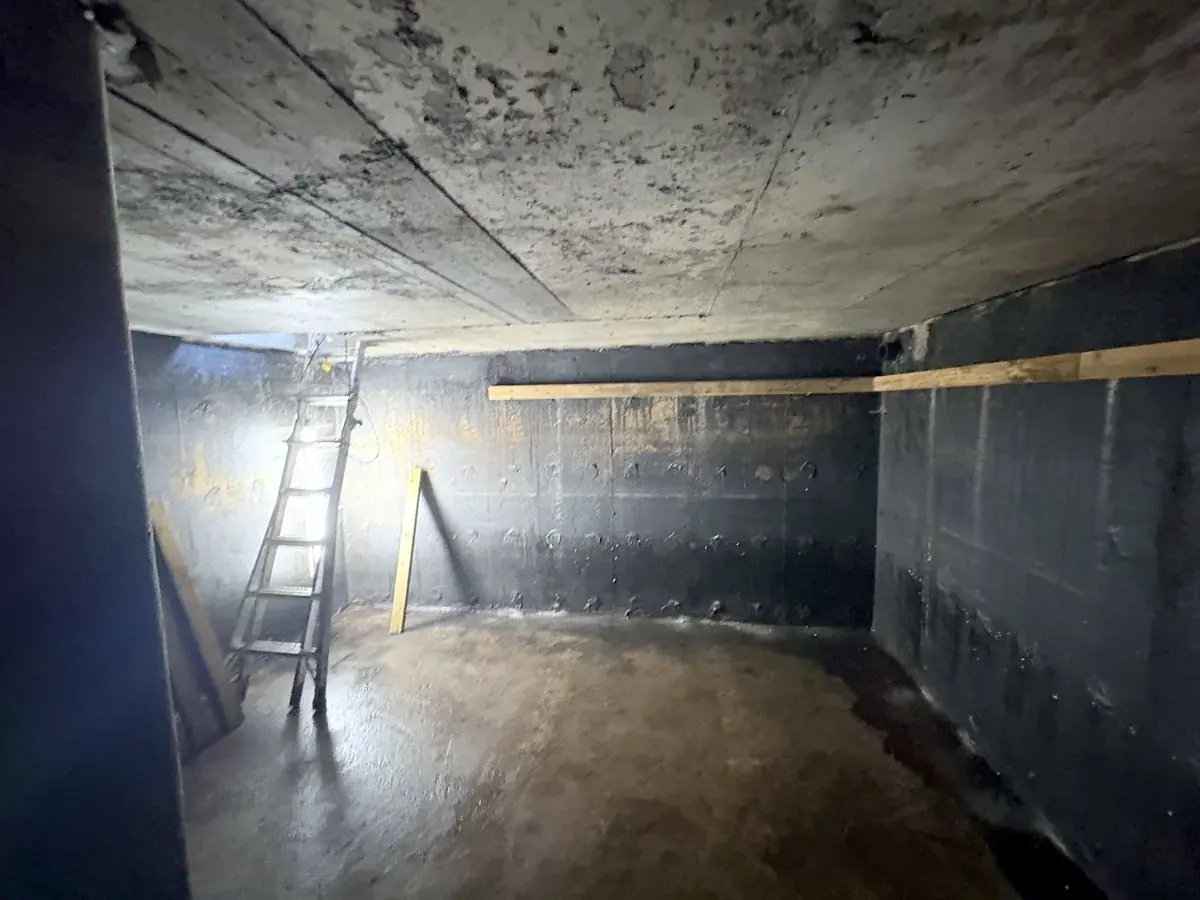

Cistern liner installation: Drained, cleaned and inspected interior, ready for strapping.
Photo 3. Drained, cleaned and inspected interior, ready for strapping.

3B. Fasten perimeter strapping with Tapcon screws

Strapping fastened around the top of the walls gives the foam and the liner a continuous, level attachment line.

  1. Mark a level line just below the ceiling, at the same height all the way around. Stay clear of penetrations and the hatch.
  2. Hold the strapping tight to the wall and run it continuously, with tight butt joints at the corners.
  3. Drill through the strapping into the concrete with a hammer drill and a carbide masonry bit matched to your Tapcon size. Drill slightly deeper than the screw will go, then vacuum the hole.
  4. Drive Tapcon screws until the head sits flush and snug. Do not over-drive. If a screw spins or snaps, drill a new hole beside it.
  5. Check by hand. Run a gloved hand and a rag along the strapping: no raised heads, protruding tips, splinters or burrs.
  6. Vacuum all dust and chips.

Follow the Tapcon maker’s chart for bit size, embedment and spacing, and wear eye, hearing and dust protection. Any raised screw head or splinter near the liner is a future puncture point.

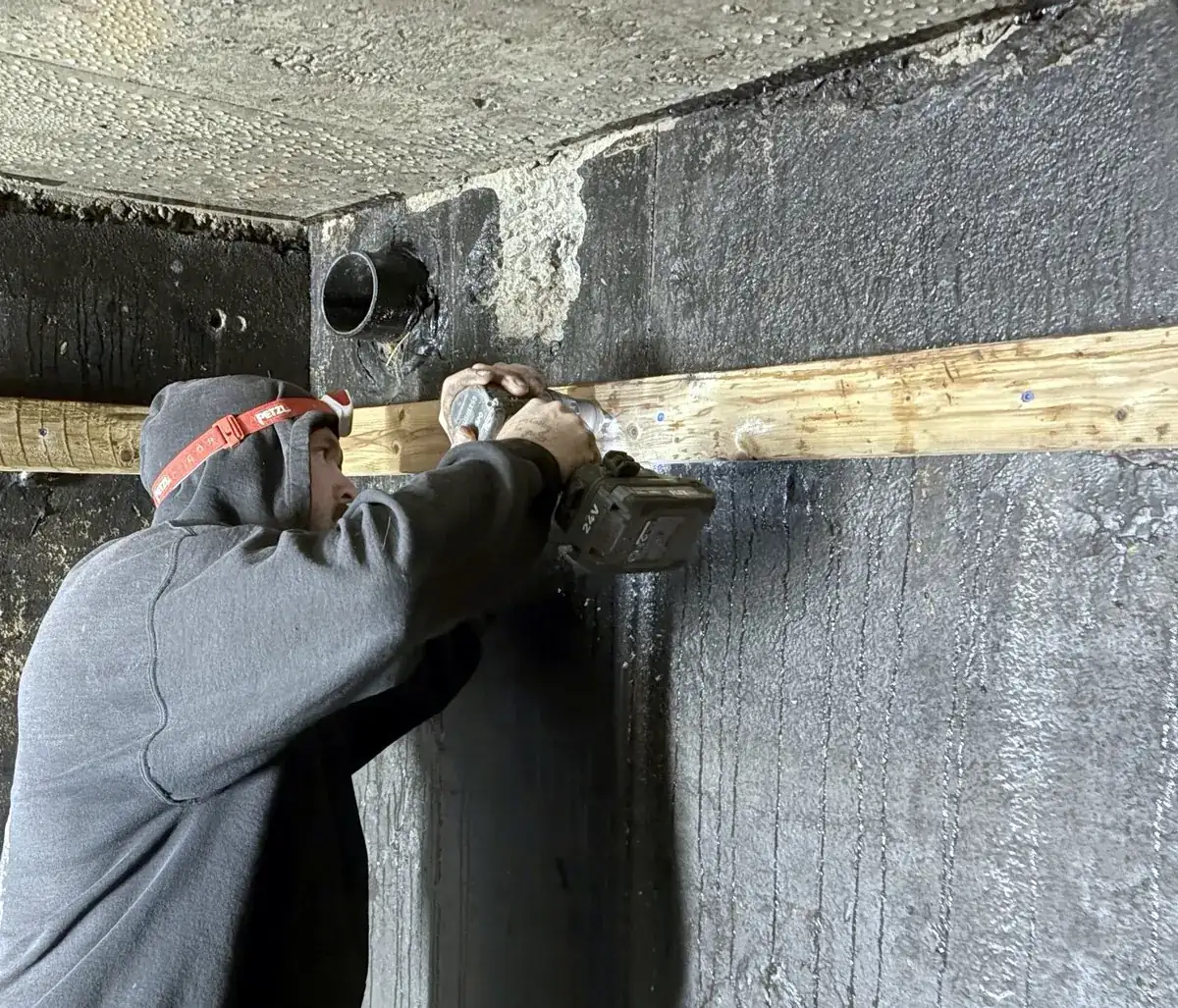

Cistern liner installation: Fastening the strapping into the concrete wall with a hammer drill.
Photo 4. Fastening the strapping into the concrete wall with a hammer drill.

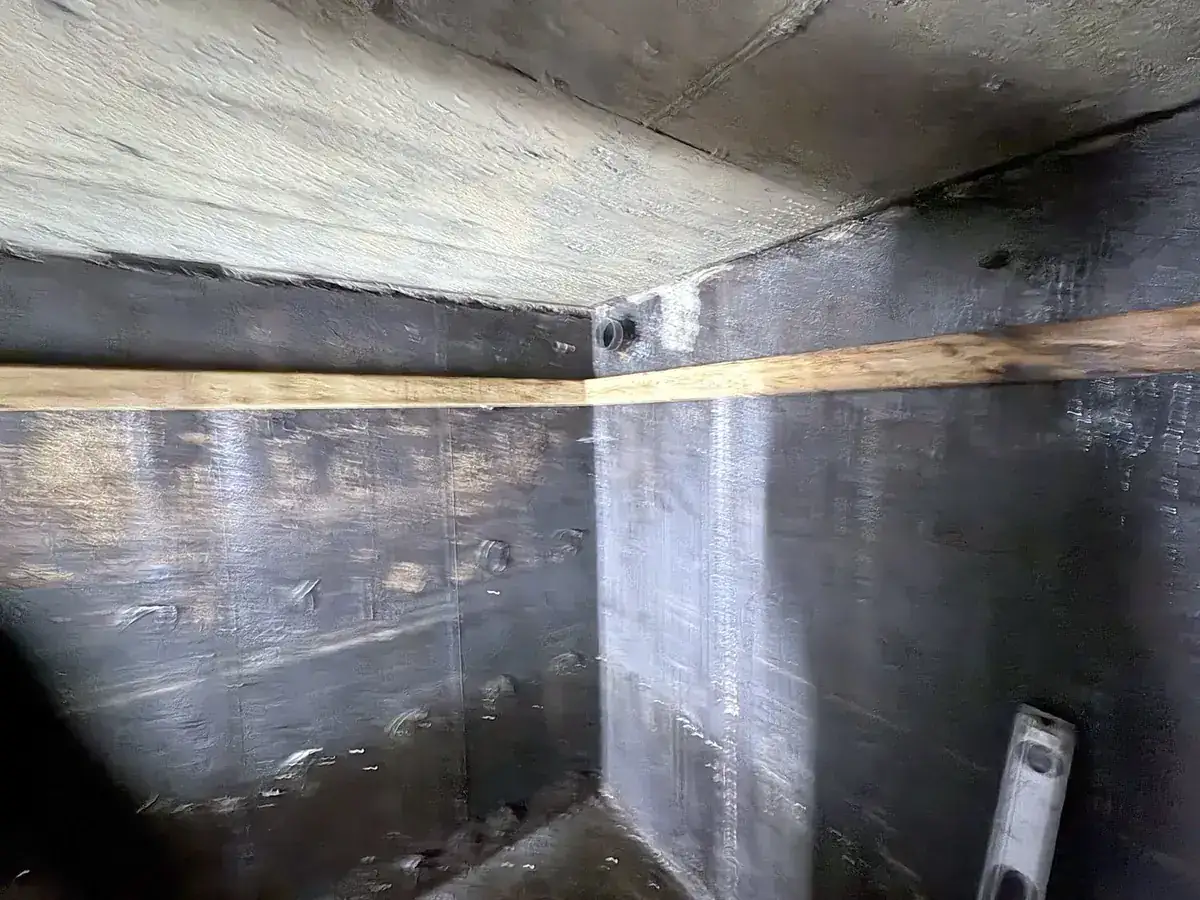

Cistern liner installation: Strapping runs level and continuous, butted tight at the corner.
Photo 5. Strapping runs level and continuous, butted tight at the corner.

3C. Protect the liner with a foam underlayment

Foam on the floor and walls separates the liner from rough concrete and old coatings. Install it completely before the liner comes anywhere near the cistern.

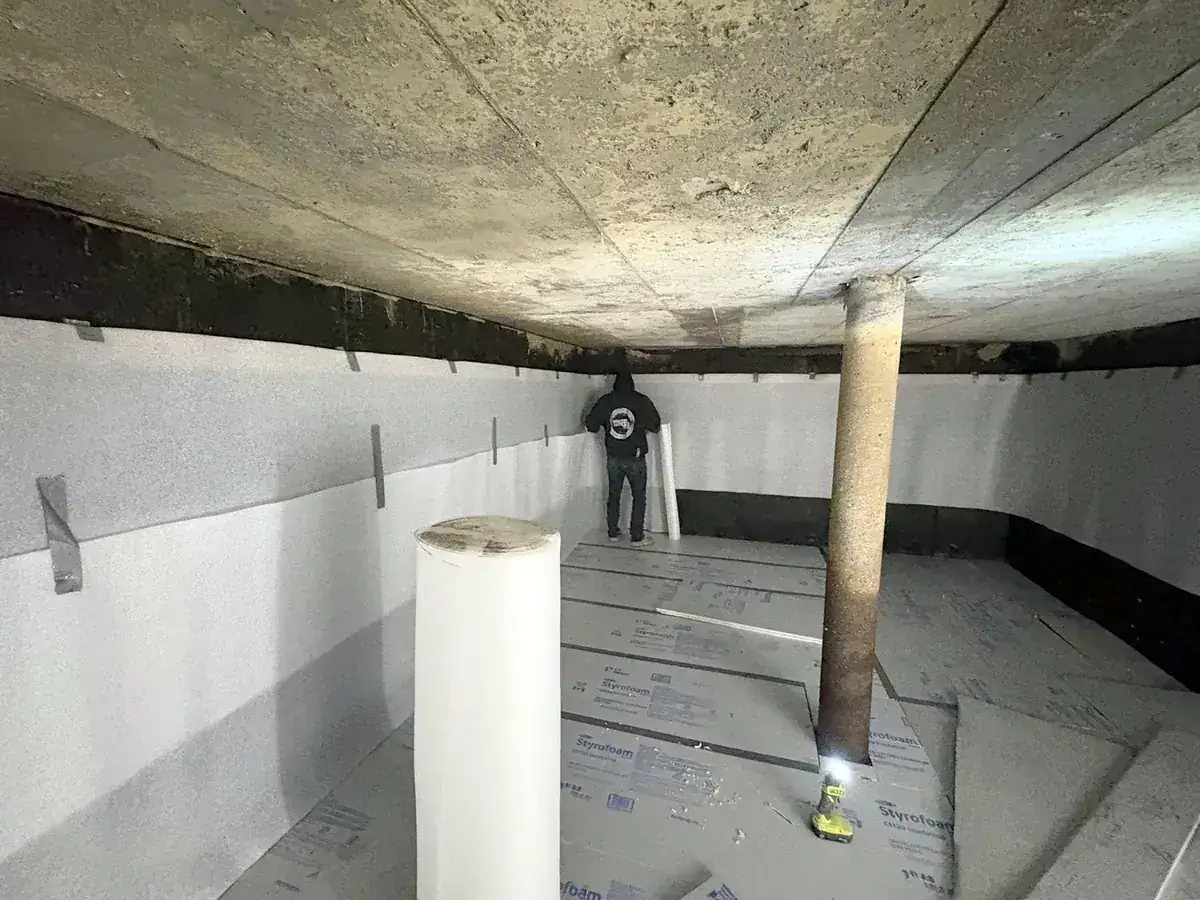

Cistern liner installation: Rigid foam boards cover the floor, wall foam hangs from the strapping and the column is wrapped.
Photo 6. Rigid foam boards cover the floor, wall foam hangs from the strapping and the column is wrapped.

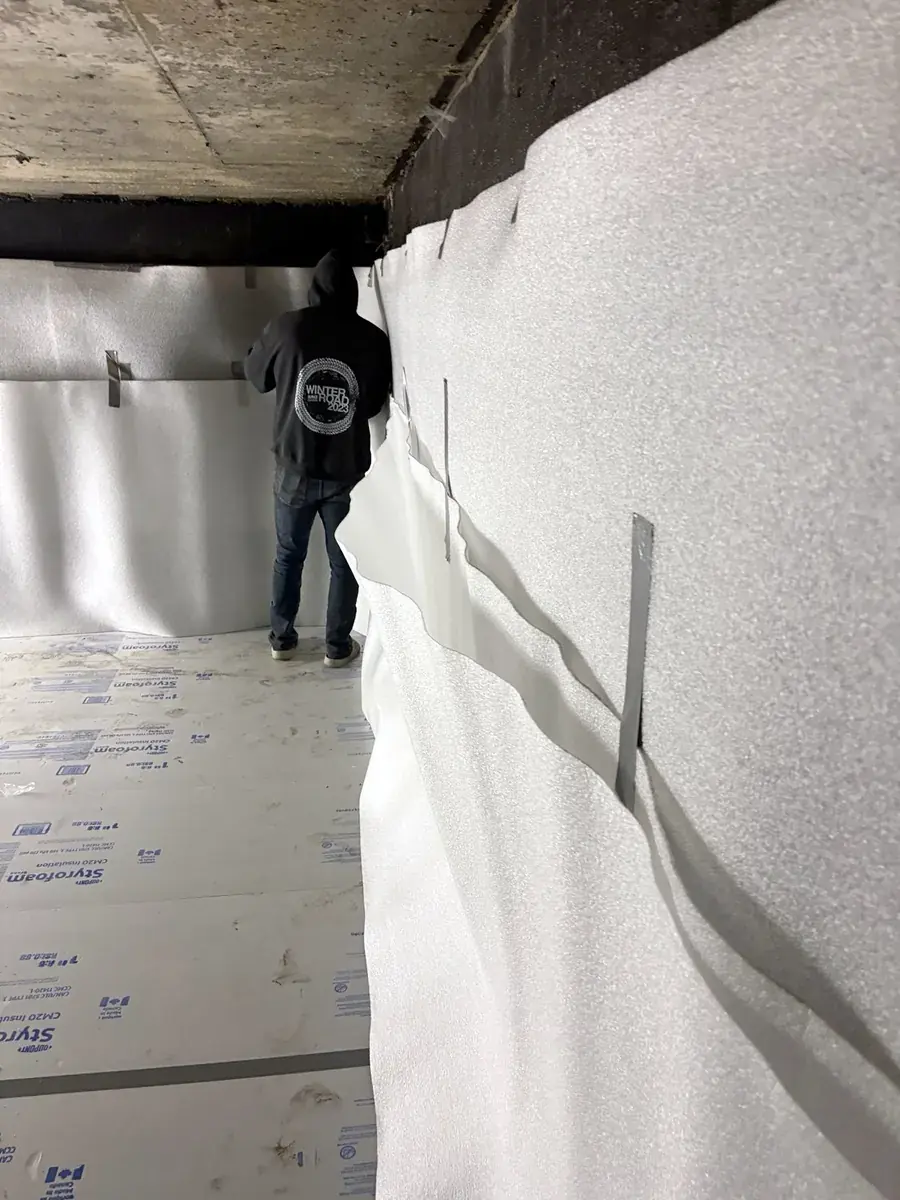

Cistern liner installation: Overlapped wall seam with temporary tape tabs.
Photo 7. Overlapped wall seam with temporary tape tabs.

Floor

  • Lay rigid foam boards tight edge to edge, staggering the joints.
  • Cut neatly around posts, drains and fittings.
  • Vacuum all foam chips and dust after cutting.

Walls

  • Hang foam sheet from the strapping in horizontal courses.
  • Hold it with flat duct-tape tabs, with no loose tails that can bunch under the liner.
  • Overlap every seam so no bare concrete or coating shows through.
  • Finish with a hand sweep to remove chips, tape ends and debris.

Posts & columns

  • Wrap each column in foam for its full height and tape it flat.
1Prepared concrete + strapping

Cleaned, smoothed surfaces with smooth, flush strapping around the top.

2Foam underlayment

Rigid foam on the floor, foam sheet on the walls, seams overlapped, columns wrapped.

3Custom liner

Positioned without stretching and secured at the strapping. Nothing sharp ever touches it.

Step 4

Position the custom liner

Unfold with care and let it sit naturally.

Before the liner enters the cistern, confirm the padded tool bag is at the opening, everyone has clean gloves and clean, soft-soled footwear or socks, and the crew agrees on orientation.

  1. Stage it clean. Open the packaging on a clean, protected surface. Never drag the liner across concrete or the ground.
  2. Identify orientation from your drawing: which walls, corners and fittings set the position.
  3. Carry it in folded and place it on the foam-protected floor, not on bare concrete.
  4. Open progressively in a controlled sequence, working from the middle out.
  5. Align the geometry: corners to corners, floor-to-wall transitions where they belong, fitting locations over their pipes.
  6. Pause and inspect. Fix twists, trapped folds or misalignment before you secure anything. Sweep a hand under and around the liner for tools, screws or debris.

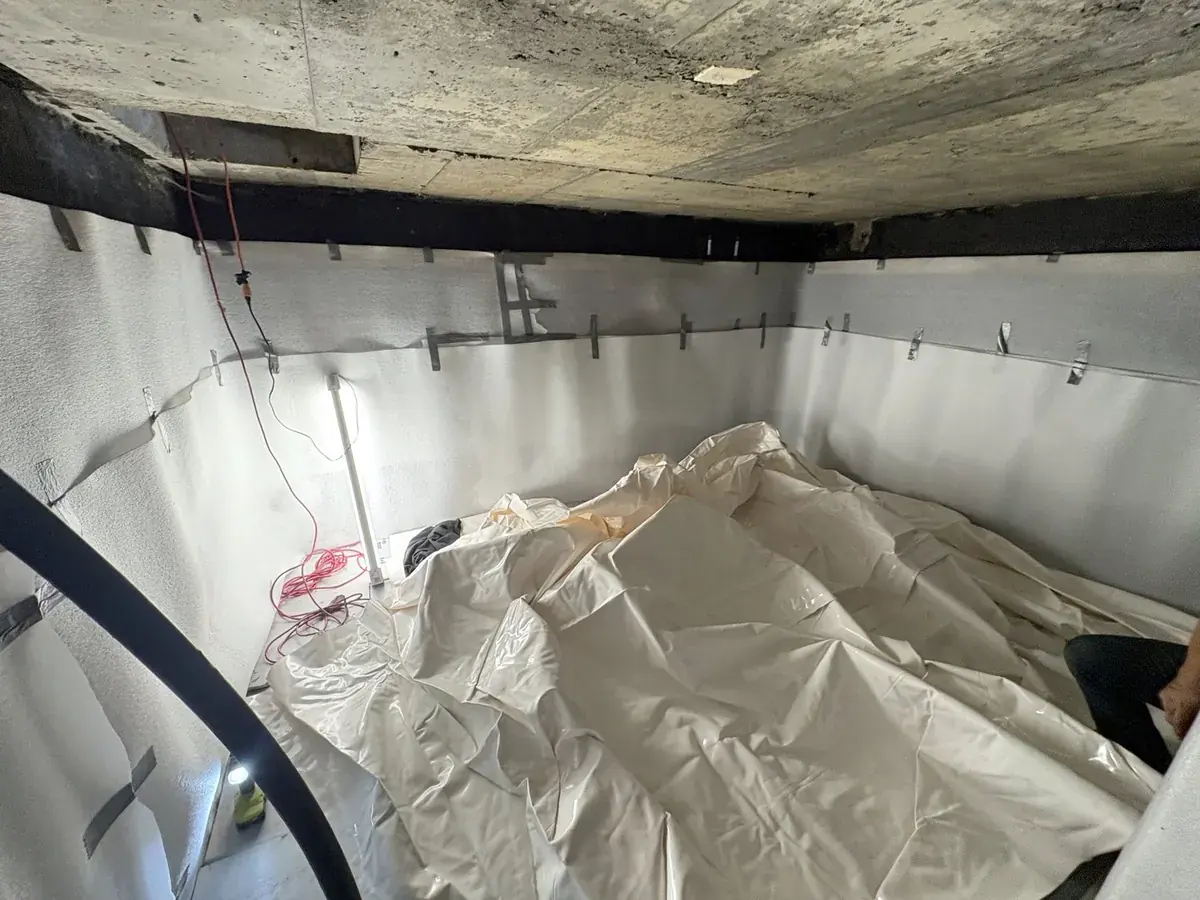

Cistern liner installation: Liner unfolded onto the foam-covered floor, with the walls ready behind it.
Photo 8. Liner unfolded onto the foam-covered floor, with the walls ready behind it.

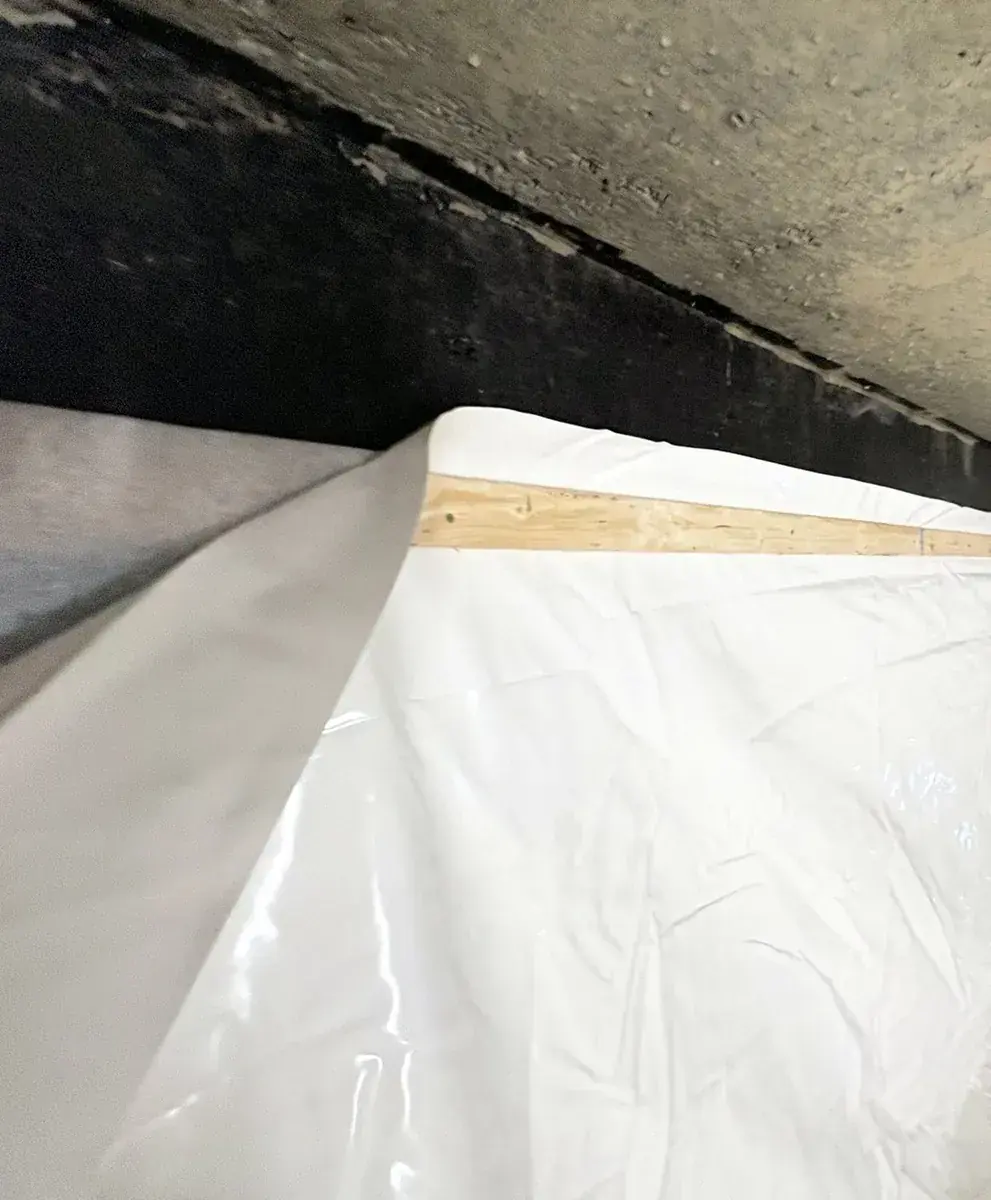

Cistern liner installation: Liner brought up to the perimeter strapping.
Photo 9. Liner brought up to the perimeter strapping.

Fit principles

  • Do not stretch the liner to force a fit.
  • Corners should sit naturally in the corners.
  • Spread temporary folds out; never bunch excess in one spot.
  • Do not trim “extra” material unless your instructions say to.

Tool control, again

  • Drill, bits and screws stay in the padded bag.
  • Never kneel or step on the liner in work boots.
  • Re-count tools and screws before leaving the cistern.
Step 5

Complete the fittings & connections

Top edge, posts, pipes and openings.

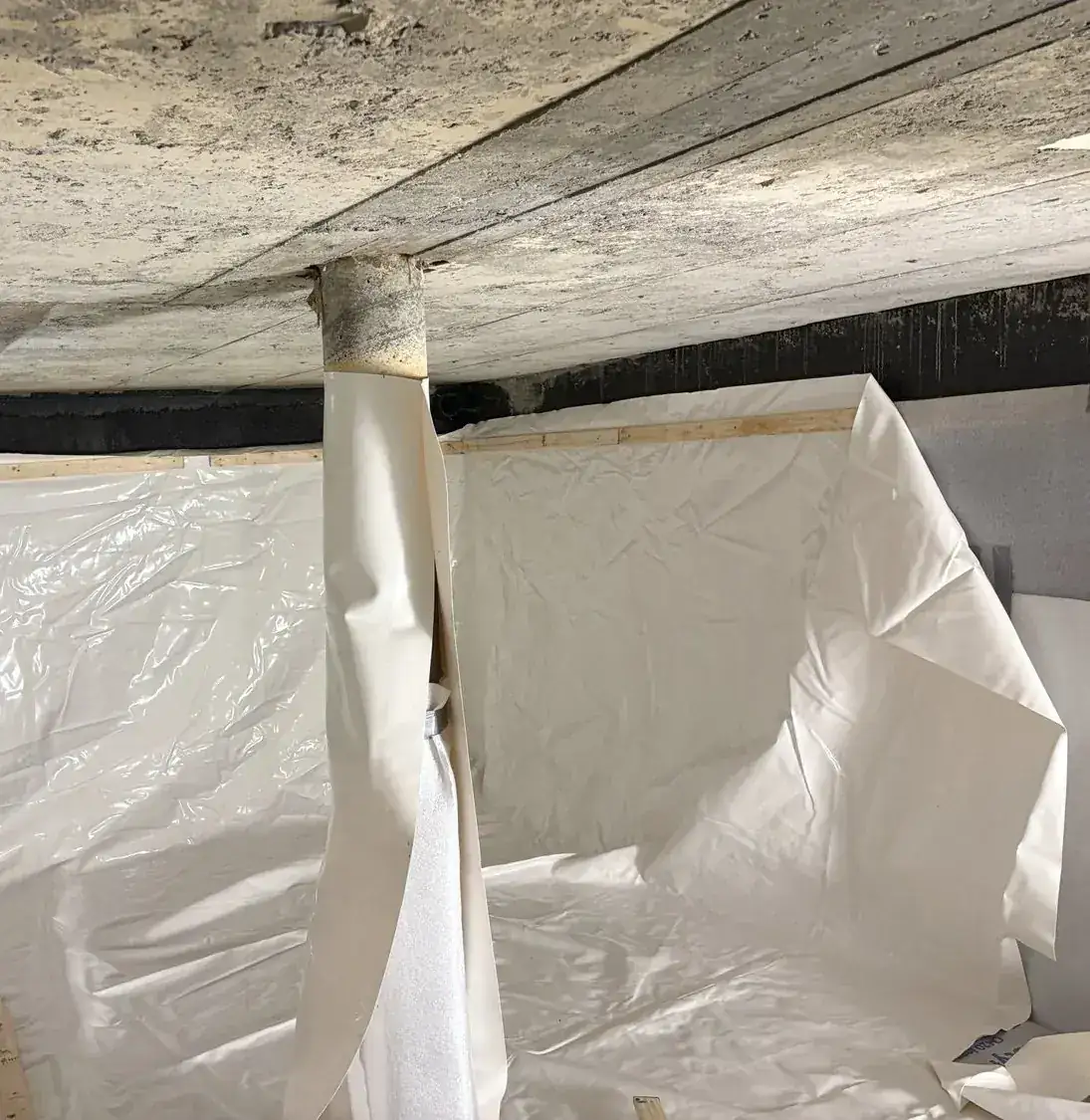

Cistern liner installation: Fabricated liner sleeve being fitted around a foam-wrapped column.
Photo 10. Fabricated liner sleeve being fitted around a foam-wrapped column.

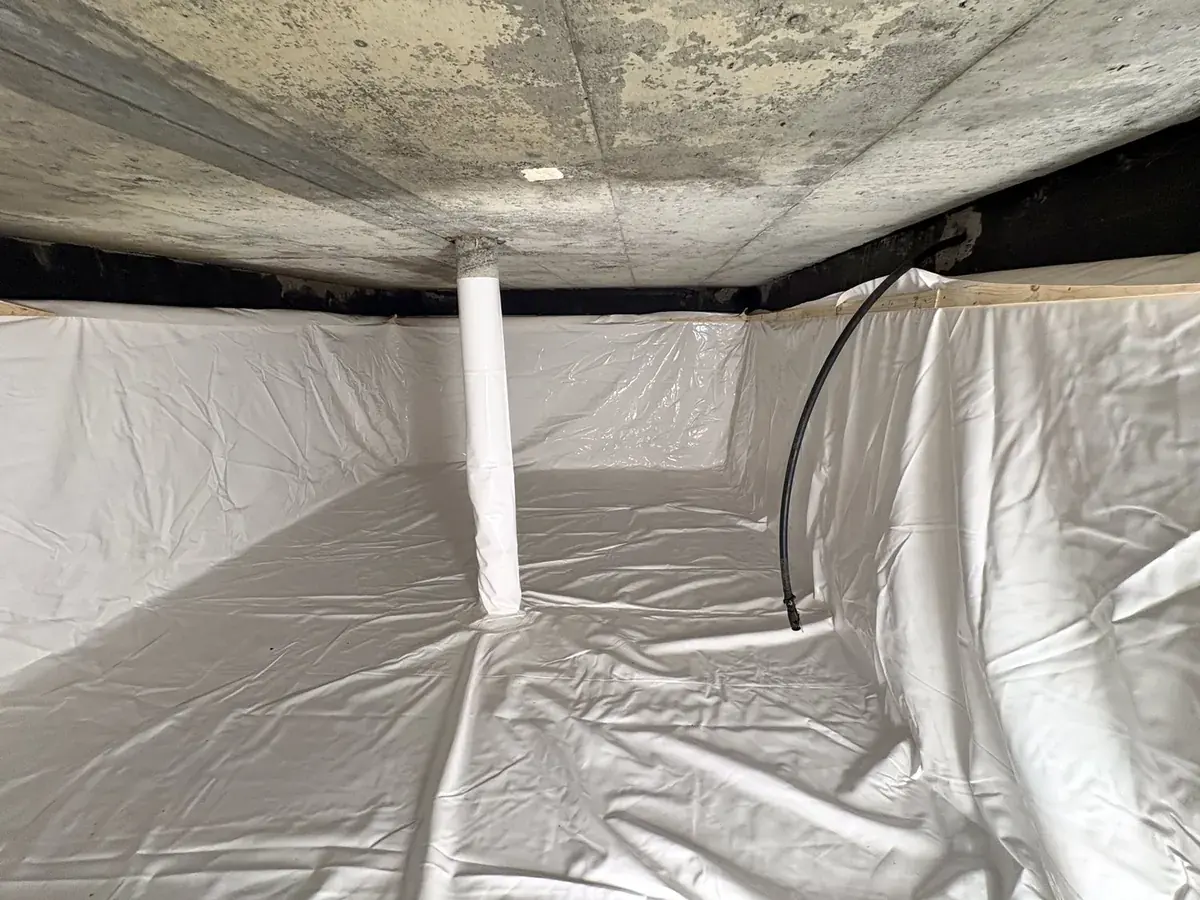

Cistern liner installation: Column sleeve in place, with a pipe penetration to the right.
Photo 11. Column sleeve in place, with a pipe penetration to the right.

Secure the top edge

  • Bring the liner edge up to the strapping and secure it with the attachment detail supplied for your project.
  • Keep tension even along the run. No stretching, no forced pulls.
  • No unapproved fasteners through the liner. Fasteners belong in the strapping, set before the liner goes in.
  • Keep the edge clear of the hatch frame and ladder brackets.

Posts & columns

  • Fit the fabricated sleeve over the foam-wrapped column, top to floor.
  • Seal the base per your project detail and smooth out any twist.

Pipes & penetrations

  • Inlets, outlets, overflows, suction lines and sensors each use the approved project-specific fitting.
  • Confirm location and orientation before you cut anything.
  • Check the right gaskets, flanges, clamps or boots are on hand and clean.
  • Support pipes independently. A liner fitting must never carry a pipe’s weight.
  • Photograph every completed fitting.

Inlet, outlet and overflow fittings

Cistern liner inlet fitting
Inlet fitting
Cistern liner outlet fitting
Outlet fitting
Cistern liner overflow drain fitting
Overflow drain

Never cut the liner to “make it fit”. If a fitting does not line up, or you are unsure of the detail, stop. Photograph the issue and call us at 1-613-985-8223 before cutting, drilling, gluing or sealing anything. At the access opening, protect the liner at the hatch, ladder and frame; most accidental damage happens on the way out.

Step 6

Inspect before returning to service

Fill slowly and watch for problems.

Corners, floor and fittings now sit square and clean. This is what a finished liner should look like before the water goes in.

Cistern liner installation: A finished corner: smooth, even, with the top edge secured at the strapping.
Photo 12. A finished corner: smooth, even, with the top edge secured at the strapping.

Before filling

  • Liner correctly oriented
  • Corners and floor transitions in place
  • No cuts, punctures or abrasion
  • All fittings completed and checked
  • Nothing trapped behind or under the liner
  • Pipes independently supported
  • Tools, screws, tape ends and packaging removed (count them)
  • Photos taken of the finished liner

While filling

  • Fill slowly with clean water so the liner settles naturally
  • Watch for pulling, tension or odd folds
  • Check accessible fittings for weeping
  • Inspect seams and openings from the access point
  • Pause if anything looks stressed, and call us
  • Do not keep filling hoping a problem will “settle out”

Handover

  • Clean and sanitize per local rules using products approved for the liner (potable water)
  • Save photos, liner ID and install date
  • Keep your warranty details
  • Record the date it returned to service
  • Inspect after any future entry into the cistern

Entering during filling: check seams and openings from the access point wherever possible. If someone must enter at low water levels, apply the same confined-space controls as before: air testing, attendant, ventilation and a clear exit.

Quick troubleshooting

If something is not behaving

Stop and work through the table below. When unsure, pause and call us.

ProblemWhat to do
Corner is far from the cistern cornerThe liner is likely rotated or a panel is twisted. Reposition before securing.
A fitting does not line upDo not force it or enlarge the opening. Confirm orientation and call us.
Cut or punctureDo not use tape or an unknown patch. Stop and request the approved repair method.
Water behind the linerStop and find the source (groundwater, leak, inlet) before continuing.
Wrinkles while fillingSome movement is normal. Investigate severe tension or trapped folds.
Concrete shedding debrisThe surface needs more prep or protection before the liner is positioned.

Take the full guide with you

The complete 9-page Installation Guide, with all 12 photos, the tools checklist and the pre-fill walk-through. Print it for installation day.

PDF, 4.5 MB. Your project drawings and supplied instructions take precedence. See our warranty for coverage terms.

Download the PDF guide
FAQ

Installation FAQs

How is a cistern liner installed?

The basic process involves emptying the cistern, preparing the interior, addressing conditions that could damage the liner, positioning the custom liner, securing it as required, and completing details around openings and fittings.

Does the cistern need to be empty?

Yes. The cistern must be drained before the interior can be prepared and the liner installed.

Does the cistern need to be cleaned first?

The interior generally needs to be clean and prepared before installation. Loose debris, sharp objects, unsuitable surfaces, and anything that could damage the liner should be addressed.

Do cracks need to be repaired before lining?

The answer depends on the nature of the cracks. The liner provides water containment, but significant structural defects should be evaluated and repaired where necessary before installation.

Do you install the liner or just manufacture it?

Cistern Liner Co. can provide liner solutions that include professional installation. Contact us with your location and project details so we can determine what service is appropriate for your project.

How long does installation take?

Installation time depends on cistern size, access, condition, preparation requirements, fittings, and project complexity. We can provide a better estimate once we understand the specifics of your cistern.

Can the liner be installed through an existing access hatch?

In many cases, yes, provided the access opening is large enough for safe installation and the configuration of the cistern allows it. Access should be reviewed during project planning.

What happens to pipes and fittings inside the cistern?

Existing penetrations such as inlets and outlets must be incorporated into the liner installation. The exact approach depends on their size, location, type, and condition.

Free quote, no obligation

Want a pro to install it?

Tell us your location and project details and we'll recommend the right service.

Call NowFree Quote
